North Hudson Sewerage Authority Weehawken Infrastructure Project Two Week Look Ahead For 2/26 - 3/8/2024

NHSA WEEHAWKEN INFRASTRUCTURE PROJECT SUMMARY:

The project's main objective is to tackle flooding problems in Weehawken by replacing and modifying sections of combined sewer infrastructure. It involves upgrading portions the sewer system on Boulevard East, Highwood Avenue, Hudson Place, and Hamilton Avenue with new piping, manholes, catch basins, and a new underground pump station.  The upgraded infrastructure will take more rainwater off the streets, and convey it to the treatment plant.  The successful completion of the project will reduce flooding and enhance the infrastructure's resilience against more frequent and intense storms.

There will be two crews working, one on Hamilton Ave and one at the pump station location on Highwood Ave. The maps on page 2-4 indicate the work areas and parking limitations.



Week 1: 2/26-3/1/2024

Hamilton Ave Crew

Hamilton Ave will be closed to through traffic. There will be no parking on Hamilton Ave in the vicinity of the work zone between Blvd East and King Ave. As construction progresses, the work zone will move down Hamilton Ave.

House Keeping

·       No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

·       Traffic signs to be posted as necessary.

Pump Station Crew

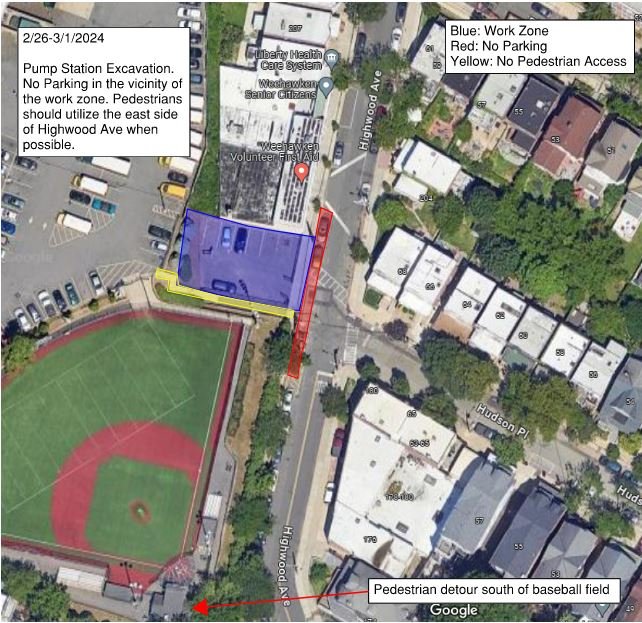

Excavation will continue at the pump station site for the second half of the pump station structure.

No parking in the close vicinity to the parling lot.

House Keeping

·       No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

·       A temporary construction fence has be installed on the sidewalk in front of the parking lot and at the top of the stairs next to the lot.

·       Traffic signs to be posted as necessary.



Week 2: 2/19-2/23/2024

Week two will be dependent on the progress in week 1. This plan will be updated after week 1.

Hamilton Ave – continuing work on Hamilton Ave. No traffic, no parking on Hamilton Ave.

Pump Station Crew – Excavation for the second part (of two part) of the pump station.

 No parking in the close vicinity to the parling lot.



Upcoming schedule:

Work on Hamilton Ave is expected to continue for 8 - 10 weeks as rock has been encountered and reduces the amount of pipe that can be installed on a daily basis.

Pump station construction is will last for 2-3 months followed by electrical work, testing, and start up.



Completed work:

Work has been completed on Blvd East from 700 Blvd East to Hamilton Ave. A new 48” PVC combined sewer was installed along with manholes and new laterals and cleanouts. The majority of work on Highwood Ave is complete, with new stormwater piping separating sewer and stormwater from Blvd East to Hudson Place. A stormwater force main was installed on Highwood Ave, that will be connected to the pump station in 2024. Hudson Place also had new stormwater and sewer piping along with new catch basins and manholes.

The first half of the pump station structure has been delivered and set at the pump station location.



Hamilton Ave Work

Hamilton Ave

Hamilton Ave

Pump Station

Pump Station

Highwood Ave / Pump Station Work

Previous
Previous

NHSA H6/H7 Phase 2: Construction & Traffic Management Activities, Feb 26 - Mar 1, 2024

Next
Next

North Hudson Sewerage Authority Weehawken Infrastructure Project Two Week Look Ahead For 2/19- 3/1/2024
