North Hudson Sewerage Authority Weehawken Infrastructure Project: Two-Week Look Ahead for June 24 - June 28, 2024

There will be one crew working on Hamilton Ave. The maps below indicate the work areas and parking limitations.



Week 1: 6/24 - 6/28/2024

Hamilton Ave Crew

Hamilton Ave will be closed to through traffic for miscellaneous wrap up activities. There will be no parking on Hamilton Ave in the vicinity of the work zone between Blvd East and King Ave. The work zone will primarily be the center of Hamilton Ave.



House Keeping

• No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

• Traffic signs to be posted as necessary.

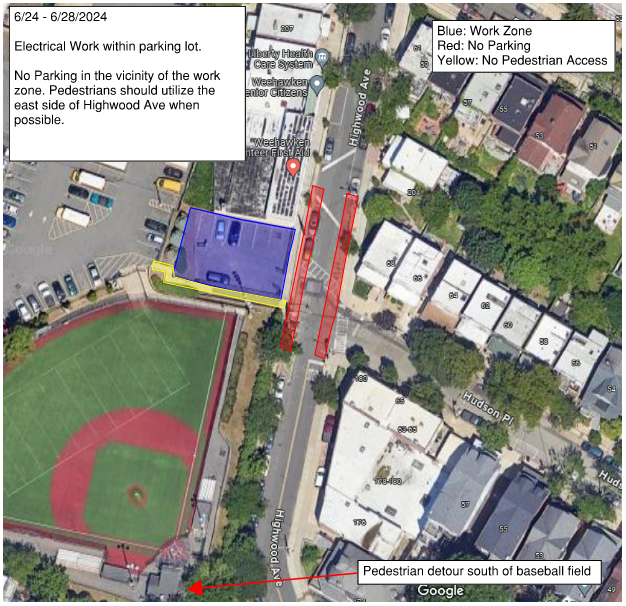

Pump Station Crew

No pump station is shut down until a permit has been received.



House Keeping

• No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

• A temporary construction fence has been installed on the sidewalk in front of the parking lot and at the top of the stairs next to the lot.

• Traffic signs to be posted as necessary.



Week 2:

No work planned week 2 due to July 4th Holiday.



Upcoming schedule:

Work on Hamilton Ave is complete.

Pump station construction is currently shut down. Construction will extend into late September and into the Weehawken School Year due to permitting delays.



Completed work:

Work has been completed on Blvd East from 700 Blvd East to Hamilton Ave. A new 48” PVC combined sewer was installed along with manholes and new laterals and cleanouts. The majority of work on Highwood Ave is complete, with new stormwater piping separating sewer and stormwater from Blvd East to Hudson Place. A stormwater forcemain was installed on Highwood Ave, that will be connected to the pump station in 2024. Hudson Place also had new stormwater and sewer piping along with new catch basins and manholes. The pump station structure has been installed at the pump station location and the force main connection has been made.

Hamilton Ave Work

Highwood Ave / Pump Station Work (No Work – Permit Delay)



Next
Next

NHSA H6/H7 Phase 2 project's construction activities and traffic management in Hoboken from June 10th to June 14th, 2024
