North Hudson Sewerage Authority Weehawken Infrastructure Project Two Week Look Ahead For 2/12 - 2/123/2024

There will be two crews working, one on Hamilton Ave and one at the pump station location on Highwood Ave. The maps on page 2-4 indicate the work areas and parking limitations.



Week 1: 2/12-2/16/2024

Hamilton Ave Crew

Hamilton Ave will be closed to through traffic. There will be no parking on Hamilton Ave in the vicinity of the work zone between Blvd East and King Ave. As construction progresses, the work zone will move down Hamilton Ave.

House Keeping

·       No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

·       Traffic signs to be posted as necessary.



Pump Station Crew

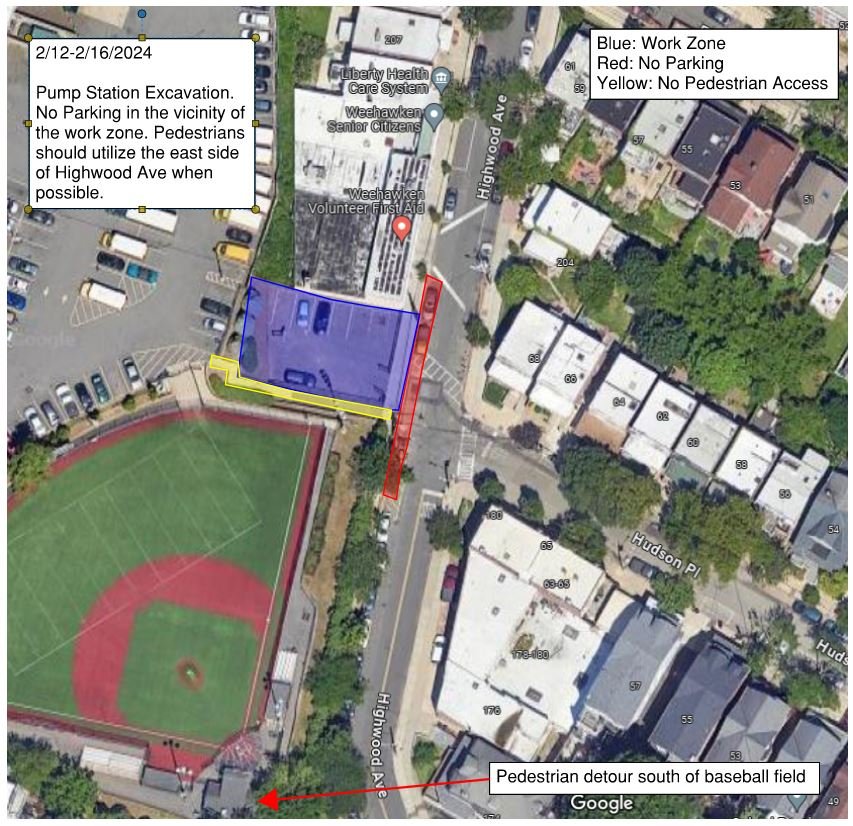

Excavation will continue at the pump station site.

No parking in the close vicinity to the parling lot.

House Keeping

·       No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

·       A temporary construction fence will be installed on the sidewalk in front of the parking lot and at the top of the stairs next to the lot.

·       Traffic signs to be posted as necessary.





Week 2: 2/19-2/23/2024

Week two will be dependent on the progress in week 1. This plan will be updated after week 1.

Hamilton Ave – continuing work on Hamilton Ave. No traffic, no parking on Hamilton Ave.

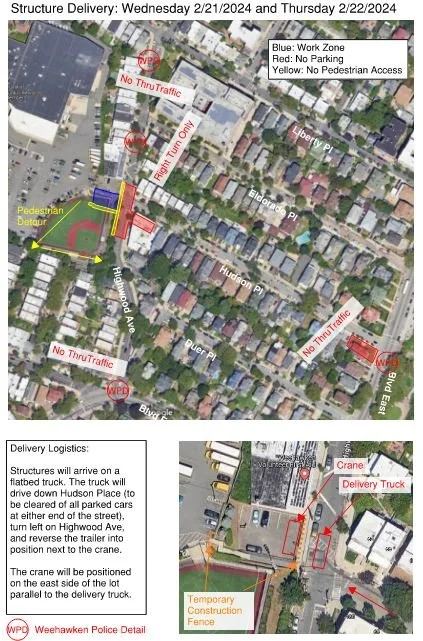

Pump Station Crew – Excavation will continue at the pump station site. A crane will arrive onsite before noon on Tuesday 2/20, there may be a temporary short road closure to get the crane positioned onsite. The Pump Station structures will be delivered on Wednesday 2/21 and Thursday 2/22. During the two days of structure delivery, Highwood Ave and Hudson Pl are closed to through traffic. Oversized Structures will be entering the work zone through Hudson Pl. No parking for approximately 100 feet at either end of the street on Hudson Place to allow for truck turning.

 No parking in the close vicinity to the parling lot.



Upcoming schedule:

Work on Hamilton Ave is expected to continue for 8 - 12 weeks as rock has been encountered and reduces the amount of pipe that can be installed on a daily basis.

Pump station construction is will last for 2-3 months followed by some electrical work and testing.



Completed work:

Work has been completed on Blvd East from 700 Blvd East to Hamilton Ave. A new 48” PVC combined sewer was installed along with manholes and new laterals and cleanouts. The majority of work on Highwood Ave is complete, with new stormwater piping separating sewer and stormwater from Blvd East to Hudson Place. A stormwater force main was installed on Highwood Ave, that will be connected to the pump station in 2024. Hudson Place also had new stormwater and sewer piping along with new catch basins and manholes.



Hamilton Ave Work

Highwood Ave / Pump Station Work

Pump Station Structure Delivery (2/21 and 2/22)
