North Hudson Sewerage Authority Weehawken Infrastructure Project: Two-Week Look Ahead for April 8th to April 19th, 2024

There will be two crews working, one on Hamilton Ave and one at the pump station location on Highwood Ave. The maps on page 2-4 indicate the work areas and parking limitations.



Week 1: 4/8-4/12/2024

Hamilton Ave Crew

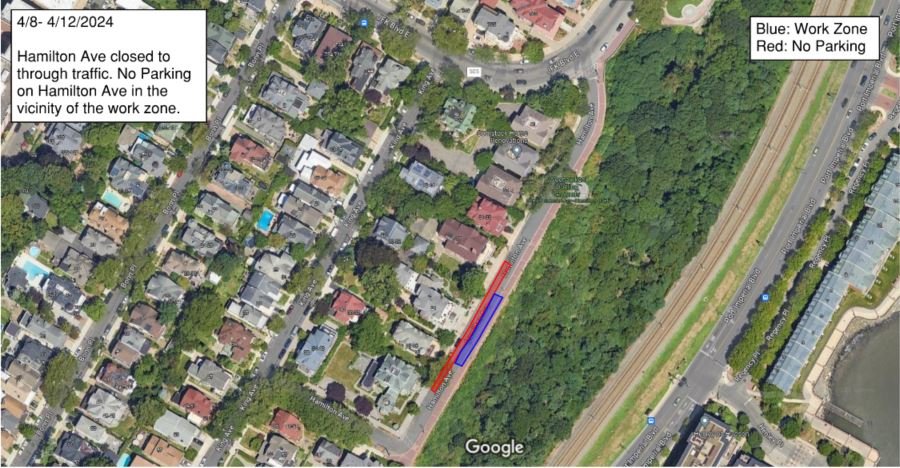

Hamilton Ave will be closed to through traffic. There will be no parking on Hamilton Ave in the vicinity of the work zone between Blvd East and King Ave. As construction progresses, the work zone will move down Hamilton Ave.

House Keeping

·       No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

·       Traffic signs to be posted as necessary.



Pump Station Crew

Pump station work includes connecting the stormwater system on Highwood Ave to the pump station. Wednesday. This installation will require Highwood Ave to be closed to through traffic during the excavation and pipe installation Monday - Wednesday.

No parking in the close vicinity to the parking lot.

House Keeping

·       No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

·       A temporary construction fence has be installed on the sidewalk in front of the parking lot and at the top of the stairs next to the lot.

·       Traffic signs to be posted as necessary.



Week 2: 4/15-4/19/2024

Week two will be dependent on the progress in week 1. This plan will be updated after week 1.

Hamilton Ave – continuing work on Hamilton Ave. No traffic, no parking on Hamilton Ave.

Pump Station Crew site work to prepare for gas and electrical connections.



Upcoming schedule:

Work on Hamilton Ave is expected to continue for 4 - 6 weeks as rock has been encountered and reduces the amount of pipe that can be installed on a daily basis.

Pump station construction is will last for 4 - 6 weeks followed by electrical work, testing, and start up.



Completed work:

Work has been completed on Blvd East from 700 Blvd East to Hamilton Ave. A new 48” PVC combined sewer was installed along with manholes and new laterals and cleanouts. The majority of work on Highwood Ave is complete, with new stormwater piping separating sewer and stormwater from Blvd East to Hudson Place. A stormwater force main was installed on Highwood Ave, that will be connected to the pump station in 2024. Hudson Place also had new stormwater and sewer piping along with new catch basins and manholes. The pump station structure has been installed at the pump station location and the force main connection has been made.

Hamilton Ave Work

Highwood Ave / Pump Station Work
