North Hudson Sewerage Authority Weehawken Infrastructure Project Two-Week Look Ahead for May 13th to May 24th, 2024

There will be two crews working, one on Hamilton Ave and one at the pump station location on Highwood Ave. The first two maps below indicate the work areas and parking limitations.



Week 1: 5/13-5/17/2024

Hamilton Ave Crew

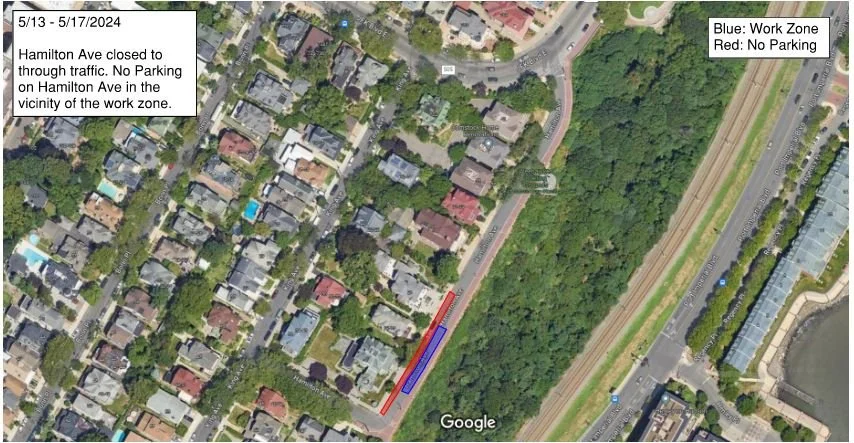

Hamilton Ave will be closed to through traffic. There will be no parking on Hamilton Ave in the vicinity of the work zone between Blvd East and King Ave. As construction progresses, the work zone will move down Hamilton Ave.

House Keeping

• No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

• Traffic signs to be posted as necessary.



Pump Station Crew

Pump station work includes light excavation and layout of electrical systems within the parking lot area.

No parking in the close vicinity to the parking lot.

House Keeping

• No vehicles, equipment, or materials will be stored on the sidewalk or in front of driveways.

• A temporary construction fence has been installed on the sidewalk in front of the parking lot and at the top of the stairs next to the lot.

• Traffic signs to be posted as necessary.



CIPP Lining Crew

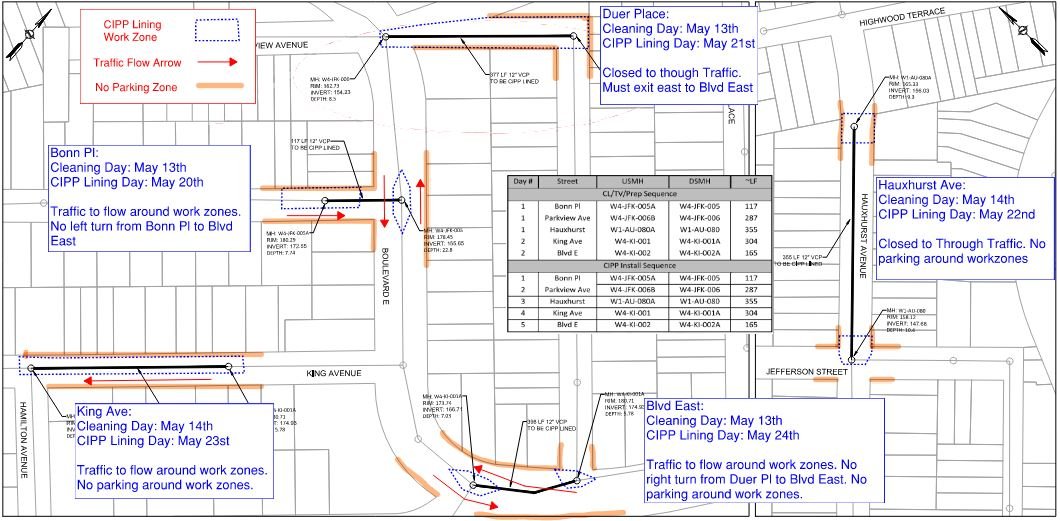

A crew will be performing sewer cleaning and inspections in preparation for cured-in-place-pipe (CIPP) lining. This work will be performed on five pipe segments in the vicinity of Blvd East. See the map below for the street sections and dates for each segment. The Town of Weehawken is providing a letter detailing the CIPP work and resident requirements for when the work is being performed on the main sewer line in front of each property.





Week 2: 4/15-4/19/2024

Week two will be dependent on the progress in week 1. This plan will be updated after week 1.

Hamilton Ave – continuing work on Hamilton Ave. No traffic, no parking on Hamilton Ave.

Pump Station Crew site work to prepare for gas and electrical connections.

CIPP Crew will be lining one main segment each day.



Upcoming schedule:

Work on Hamilton Ave is expected to continue for 10-12 weeks as rock has been encountered and reduces the amount of pipe that can be installed on a daily basis.

Pump station construction is will last for 6-8 weeks followed by testing, and start up.



Completed work:

Work has been completed on Blvd East from 700 Blvd East to Hamilton Ave. A new 48” PVC combined sewer was installed along with manholes and new laterals and cleanouts. The majority of work on Highwood Ave is complete, with new stormwater piping separating sewer and stormwater from Blvd East to Hudson Place. A stormwater forcemain was installed on Highwood Ave, that will be connected to the pump station in 2024. Hudson Place also had new stormwater and sewer piping along with new catch basins and manholes. The pump station structure has been installed at the pump station location and the force main connection has been made.

Hamilton Ave Work

Highwood Ave / Pump Station Work

CIPP Lining

Previous
Previous

North Hudson Sewerage Authority (NHSA) H6/H7 Phase 2 - Construction and Traffic Management Activities in Hoboken from May 20, 2024 through May 24, 2024

Next
Next

Construction Activities and Traffic Management Update: NHSA H6/H7 Phase 2 Project in Hoboken May 6-10, 2024
